Most hotel FF&E procurement Riyadh delays are not sourcing issues. They are coordination failures between suppliers, timelines, and site readiness.
Running hotel FF&E procurement in Riyadh means managing dozens of categories, multiple vendor timelines, and a handover date that does not shift. Most delays in hotel FF&E procurement Riyadh projects are not caused by bad products. They come from fragmented sourcing: multiple vendors on separate timelines, no single point of accountability, and shipments arriving in whatever sequence is convenient for each supplier. Finish mismatches show up on site. Customs entries multiply. Storage fills with goods that cannot be installed yet because the floors are not ready.
This guide covers the procurement model that prevents most of that, a BOQ-led execution framework, and a supplier scorecard to shortlist partners before the first RFQ goes out.
Quick Answer: What is the safest way to procure hotel FF&E in Riyadh without vendor chaos?
The model you choose determines how much coordination overhead you carry for the life of the project. Here is how each one performs on a multi-category Riyadh hotel project.
Supplier Model | Best For | Key Risks | How to Mitigate |
Local Dealer / Reseller | Fast top-ups, standard SKUs | No multi-category coverage, no QC proof or milestone tracking | Use for urgent small orders only, never as a primary route |
Multiple Manufacturers (self-coordinated) | Category specialization | Fragmented timelines, inconsistent QC, high coordination overhead | Needs a dedicated internal procurement lead per category cluster |
Single-Window Procurement Partner (Recommended) | Multi-category BOQs, one timeline, QC, and logistics ownership | Must verify milestone tracking and QC evidence standard before engaging | Request a sample milestone report and QC evidence pack upfront |
Hybrid Model | Speed plus value across project phases | Accountability gap between local and international streams | Assign one partner as the sequencing owner across both supply streams |
The single-window model concentrates accountability in one place. When a milestone slips, you call one number. There is no gap between the sourcing party and the QC party for problems to fall into. The other models cannot replicate that, regardless of how well-coordinated each individual supplier is.
The best model for hotel FF&E procurement Riyadh projects is a single-window procurement partner who manages sourcing, quote comparison, QC, logistics, and delivery sequencing under one timeline. This cuts vendor coordination overhead, keeps quality consistent across categories, and aligns all delivery schedules to the project handover date.
Vendor chaos is avoided by working from a locked BOQ, standardizing RFQs across all suppliers, using a milestone tracker tied to each PO, running pre-shipment QC checks before dispatch, and consolidating shipping with delivery sequencing by floor or zone. This creates one coordinated timeline instead of multiple disconnected vendor schedules running in parallel.

This is the BOQ-to-PO process that keeps Riyadh hotel projects on timeline without daily vendor follow-up becoming a full-time job.
Step | Action | Why It Matters |
01 | BOQ and spec freeze with budget bands and target handover date | No supplier can quote fairly without a locked reference |
02 | Supplier shortlist plus category alternates for risk coverage | Alternates are your insurance against single-source delays |
03 | RFQ issuance and apples-to-apples quote comparison matrix | Every quote must reference the same BOQ line item codes |
04 | Sample and mockup sign-off with retained counter-sample | Finish mismatches are caught here, not on site |
05 | PO issuance tied to milestone tracker across all categories | Milestones replace daily follow-up calls with structured reporting |
06 | QC checkpoints and photo or video evidence pack before dispatch | PSI evidence pack becomes your site acceptance baseline |
07 | Consolidated shipping plan grouped by delivery zone, not supplier | Reduces customs entries, storage congestion, and handling risk |
08 | Delivery sequencing by floor and zone, with installation coordination support | Delivered does not mean installed. Sequencing prevents storage damage. |
Most project managers underestimate sampling. It gets treated as a quick formality, then a finish comes back wrong, and three weeks are gone. Build every phase into your programme from the start.

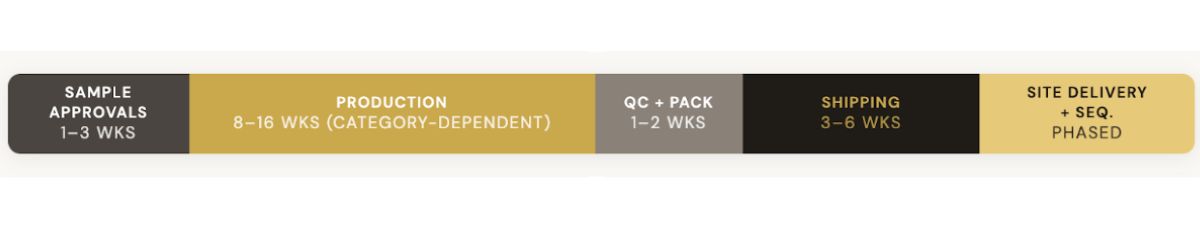

Phase | Typical Duration | Risk If Rushed |
Sample Approval | 1 to 3 weeks | Finish mismatch requires full batch replacement on-site |
Production | 8 to 16 weeks | Rush orders produce tolerance failures and surface defects |
QC and Export Packing | 1 to 2 weeks | Transit damage and hardware failures were discovered after delivery |
Shipping to Riyadh | 3 to 6 weeks | Fragmented dispatches multiply customs and port bottlenecks |
Site Delivery and Sequencing | Phased by zone | Storage damage and gaps delay MEP and FF&E co-installation |
The 8-to-16-week production window is the one suppliers will try to compress. Sometimes they pull it off. More often, tolerance failures and surface defects show up when the furniture is on site, and the installation team is already standing next to it.
Riyadh is not a generic Gulf market. Teams that have procured FF&E for projects in other cities consistently underestimate the on-ground complexity here. With Vision 2030 driving a large pipeline of hotel and hospitality projects across the capital, the pressure on timelines is higher than most procurement managers expect coming in. Four issues come up more often than any others.
KSA customs clearance is not predictable. Clearance timelines vary based on documentation completeness, HS code classification, and port congestion at Jeddah Islamic Port or King Abdulaziz Port Dammam. A shipment with incomplete certificates of origin or missing material composition declarations can sit for weeks. Build that buffer into your programme before a supplier tells you to. Most hotel FF&E procurement Riyadh delays do not happen at sourcing. They happen between port clearance and site delivery.
Inland logistics from the port to the Riyadh site add time and handling risk. The Riyadh region sits roughly 900km from the nearest major port. That inland leg is where damage from improper loading and unloading happens. It is also where fragmented shipments get separated from their manifests. Consolidated shipments with full zone manifests travel cleaner than 15 separate consignments.
Site access in Riyadh hotels and mixed-use developments is restricted. Many active projects in Riyadh operate under timed delivery windows, require contractor vehicle registration and access permits, and have restricted crane or lift access during specific phases. Tower projects add further constraints around night delivery windows and shared logistics corridors across multiple contractors. Delivery sequencing by floor and zone is not just a logistics preference here. It is a site reality. A shipment that arrives before the floor is ready has nowhere to go.
Multi-phase handovers are the norm, not the exception. Large hospitality projects in KSA frequently open in phases. That means your FF&E programme needs to track separately against each phase handover date, not a single project completion date. A procurement partner who does not build phase-level milestone tracking into the BOQ-to-PO workflow will create problems at the point when the first phase is handed over and the second is still in production.
This is why consolidated shipping and delivery sequencing matter more in Riyadh than in almost any other market. One accountable partner managing the full logistics chain from factory to floor is the only way to absorb these variables without losing the timeline.

Make this evidence pack a mandatory condition in your PO terms. No dispatch note should be accepted without it.
Checkpoint | What to Verify |
Finish Match | Colour, texture, and sheen checked against retained counter-sample |
Dimensions vs BOQ | Critical dimensions within agreed tolerance, typically plus or minus 2mm |
Hardware Testing | Hinges, drawer runners, and sliders tested through 50-cycle minimum |
Surface Inspection | Chips, dents, finish pooling, and joint gaps on all exposed faces |
Export Packaging | Edge guards, corner guards, moisture barrier, and carton drop-test verified |
PSI Evidence Pack | Photo and video walkthrough issued with every dispatch note |
The counter-sample step is the one most teams skip. It feels like paperwork until 400 units arrive in the wrong finish with no documentation proving what was approved. Keep a signed counter-sample after sign-off. It takes ten minutes.

When every supplier ships independently, your site receives random deliveries. Customs entries multiply. Storage fills with goods that cannot be installed yet because the floors are not ready. Your site manager ends up running a warehouse operation instead of managing an installation programme.
Challenge | Fragmented Shipping | Consolidated and Sequenced |
Customs Entries | One per supplier, often 10 to 15 separate entries | Batched into 2 to 4 entries for the same total volume |
Site Storage Congestion | Everything arrives before install readiness | Arrivals matched to the floor and zone handover schedule |
Team Coordination Load | Site manager chasing 15 to 20 shipping contacts | One partner, one delivery schedule, one point of contact |

The safest hotel FF&E procurement Riyadh projects run on a locked BOQ, one accountable sourcing and procurement partner, structured milestone tracking, QC before dispatch, and consolidated delivery sequencing aligned to installation readiness.
If your project has a fixed handover date, this approach removes vendor chaos and keeps execution on track from sourcing to site delivery. A fragmented approach does not get cheaper as the project progresses. It gets harder to fix.
Share your BOQ, Riyadh site location, and target handover date to receive a sourcing plan, milestone tracker, QC checkpoints, and delivery sequencing strategy aligned to your installation programme.
Arcedior works as a single-window sourcing, procurement, QC, and logistics coordination partner for hotel projects across Riyadh and KSA. No design. No turnkey. Procurement execution only.
What is the best FF&E supplier model for Riyadh hotel projects?
A single-window procurement partner is the right model for multi-category hotel FF&E procurement Riyadh projects. They own the timeline across all categories, compare quotes on equal terms, and coordinate QC and consolidated shipping under one accountability structure. Use local dealers for urgent small-volume top-ups only, not as your primary procurement route.
How do I compare multiple FF&E supplier quotes fairly?
Use a quote comparison matrix where every supplier quotes against the same locked BOQ. Columns must include unit price, lead time, packing standard, warranty, and payment schedule. Any quote missing your BOQ item codes line by line cannot be fairly compared and needs to be reissued before evaluation.
How do I prevent finish mismatch after sample approval?
Retain a counter-sample with a signed approval at sign-off. Your QC team checks production output against this retained sample during pre-shipment inspection. Never authorize production start without a signed sample in hand. This one step prevents most finish mismatch problems that would otherwise be found during installation.
What QC checks must happen before hotel furniture is dispatched?
Pre-dispatch QC must cover finish match against the approved sample, dimension tolerances per BOQ, hardware cycling tests, surface inspection across all exposed faces, and a photo and video PSI evidence pack. Build this into your PO terms so it travels with every dispatch note as your site acceptance baseline.
How should consolidated shipping work for hotel FF&E to Riyadh?
Your procurement partner batches goods by delivery zone or floor at origin, not by individual supplier. This reduces customs entries, generates a full zone manifest before each delivery, and aligns the shipping schedule with installation readiness. Installation teams receive complete zone sets, not partial batches across multiple separate deliveries.
What are the most common mistakes in hotel FF&E procurement in Riyadh?
Five account for most delays: issuing RFQs before the BOQ is locked, starting production without a signed sample approval, letting every supplier ship independently, underestimating how long sampling and QC take, and having no single accountability owner across the full multi-category BOQ procurement Riyadh programme.
How does a milestone tracker reduce vendor chaos on Riyadh hotel projects?
Each PO ties to checkpoints covering raw material, production start, mid-run QC, finishing, packing, and dispatch readiness. When a milestone slips, your procurement partner escalates it. Your site team is not chasing suppliers across time zones while managing an active multi-category installation programme.
What do you need from me to start FF&E procurement for a Riyadh hotel project?
Share your BOQ or item specifications, Riyadh site location, target handover date, and budget bands per category. Arcedior replies with sourcing routes, a production milestone plan, QC checkpoints, a consolidated shipping approach, and a delivery sequencing proposal aligned to your installation programme.
What should be included in an FF&E quote for Riyadh hotel projects?
A complete FF&E quote must include BOQ line items, unit pricing, lead times, packaging standards, QC scope, warranty, and delivery terms. Without this structure, quotes cannot be compared on equal terms, and scope gaps and cost overruns tend to surface during execution rather than during evaluation.
How does delivery sequencing by floor reduce delays on Riyadh hotel sites?
Delivery sequencing ensures FF&E arrives floor by floor or zone by zone based on installation readiness. This reduces storage congestion, prevents handling damage from goods sitting too long on site, and lets installation teams work without waiting for missing items from fragmented shipments.
Ready to Shortlist Your Procurement Partner?
Share your BOQ or specs, Riyadh site location, and target handover date. Arcedior will reply with sourcing routes, milestone plan, QC checkpoints, consolidated shipping approach, and delivery sequencing by floor or zone.
