Your opening date is fixed. Floors are getting handed over. But if your hotel FF&E delivery schedule for Dubai is built around a single shipping ETA rather than a floor-wise handover plan, you are already heading toward the most common Dubai hotel opening crisis: furniture arriving on site before rooms are ready, vendors blocking each other in corridors, and a punch-list that explodes in the final two weeks, putting your entire hotel opening date risk at stake.
A practical hotel FF&E delivery schedule for Dubai connects production tracking, pre-dispatch QC gates, delivery slot booking, and room-wise labeling into one coordinated system, so FF&E logistics coordination delivers the right item to the right room, on the right floor, when installers are ready.

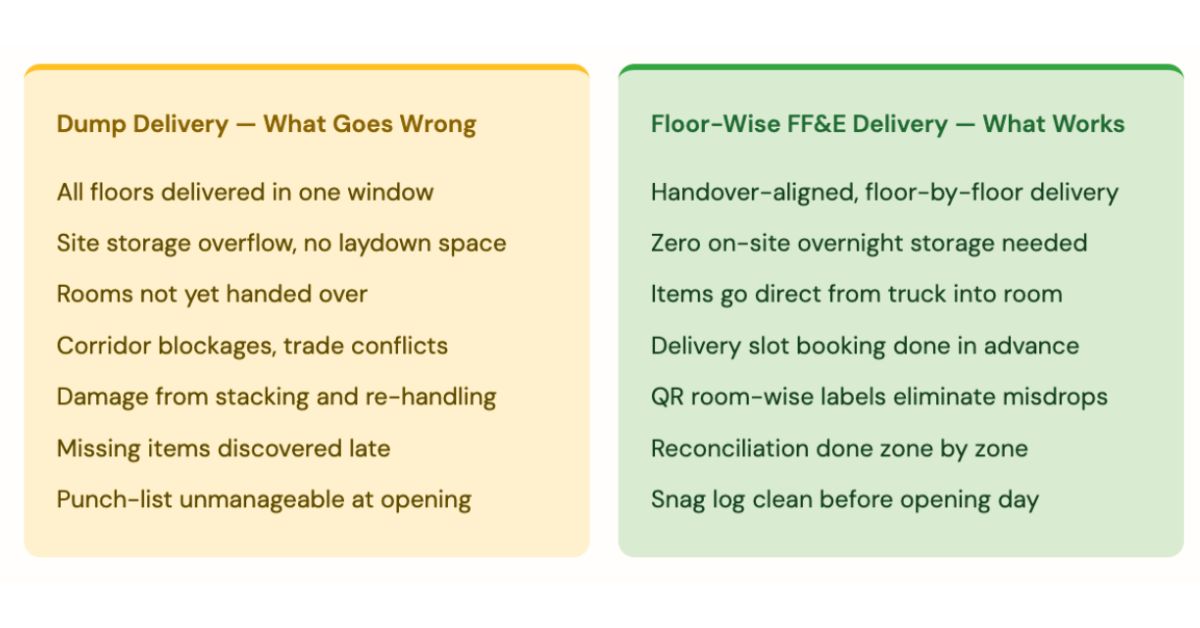

Instead of bulk “dump deliveries,” FF&E moves through the site in controlled batches that match real installation capacity. This approach reflects how hospitality procurement projects executed by Arcedior manage multi-vendor FF&E without disrupting live construction environments.
Creating an effective schedule starts with one non-negotiable input: confirmed floor-wise handover dates from the main contractor. Every downstream decision – vendor production milestones, QC gate timing, delivery slot booking, and room labeling – flows from that single source of truth.
Work backwards from each floor's handover date. Plot the dispatch window required for QC, freight, and site access. Then set production start dates per vendor category – casegoods, soft furnishings, loose furniture, and hardware kits, so each category arrives in a delivery window that matches real installer capacity on that floor.

Example:
If Level 8 guestrooms are cleared and handed over, but Level 9 is still under MEP testing, then:

Step-by-Step FF&E Delivery Scheduling System – BOQ Freeze to Snag Closure

Lock the full BOQ with room-wise splits, finish codes, hardware specs, and tolerance ranges before any RFQ goes out. Split guestrooms, lobby, F&B, and BOH into separate delivery tracks. Vague BOQs cause 2 to 4 weeks of revision delays that cascade into the entire FF&E delivery schedule.
Confirm handover dates per floor from the main contractor. In Dubai, freight lift access requires advance delivery slot booking – sometimes weeks out. Plot all access windows into the master calendar before production orders are placed, or your sequencing plan is built on assumptions.
Sequence FF&E by install priority within each floor: guestrooms first, corridors second, public areas third. Create an FF&E staging plan per zone that gives the install team a clear order and staging location for each item category without improvising on-site.

Freeze finishes and mockup sign-offs before production scales. Late approvals are the leading cause of hotel FF&E delivery schedule slippage in Dubai projects. Set hard approval deadlines and use a mockup room to align all stakeholders in one visit.
Demand weekly photo and video production milestone updates at every gate: raw material ready, fabrication complete, assembly done, finishing approved. A per-vendor production milestone tracker catches a six-week delay before it becomes a shipping crisis and a missed opening date.
Before any container is loaded, run the pre-dispatch QC checklist: finish match, dimensions, hardware, surface quality, and packaging validation. The evidence pack, photos, and video – travels with shipment documents so site teams cross-reference every item on arrival.
Use room-wise QR labels on every carton. Reconcile received versus expected against the packing list, the same day delivery arrives. Log all snags immediately with the owner, resolution method, and target date. Punch-list and snag closure done floor-by-floor is the only approach that holds the opening date.
A floor-wise plan assigns every item category a delivery window tied to that floor's confirmed handover date. The schedule is not static – it is a rolling 2-week look-ahead updated as handover dates shift, production gates are cleared, or delivery slot availability changes.
The floor-wise plan covers: confirmed handover date per floor → delivery window (48–72 hr install rule) → item categories dispatching in that window → booked freight lift slot → staging zone assignment per room type → reconciliation checkpoint.
Imported FF&E arriving via Jebel Ali must be sequenced against floor readiness, not port arrival dates. Customs clearance variance of 3–7 days must be buffered into the dispatch timing at the vendor production stage, not absorbed on site.
Staging on a Dubai hotel site is not improvised storage; it is a pre-mapped zone assignment tied to the install sequence. Every item category has a designated staging location per floor, and nothing is placed in circulation areas, fire escape corridors, or MEP zones.
Effective staging reduces re-handling, protects finished surfaces, and gives installers a predictable flow from staging zone to room. An FF&E staging plan is built at the same time as the floor-wise delivery calendar, not on the morning of delivery day.
A complete hotel FF&E delivery schedule Dubai template tracks six data layers. Any gap becomes a site problem during install week when there is no time to chase missing information.
Data Layer | Fields to Track | Why It Matters |
Location | Floor, zone, room number, room type | Drives sequencing and the room-wise label system |
Item | Category, description, quantity, finish code | Enables packing list reconciliation at delivery |
Vendor | Supplier name, production milestone, QC status | Identifies delivery risk before dispatch |
Logistics | Dispatch date, ETA to site, booked delivery slot | Ties directly into the Dubai site access windows |
Staging | FF&E staging plan location, installer window, and install status | Controls congestion and installs flow on site |
Reconciliation | Received qty, damage noted, snag owner, resolution date | Closes the punch-list cleanly before handover |

Every defect caught at the factory during the pre-dispatch QC inspection costs a fraction of what rework costs on a live Dubai hotel site. This QC gate is non-negotiable in any FF&E procurement and logistics coordination plan that is serious about protecting the opening date.
Arcedior applies this QC gate across all hospitality projects, including the Indore Marriott and Taj Skyline Ahmedabad – before any container is sealed. The evidence pack travels with shipment documentation to every Dubai site.

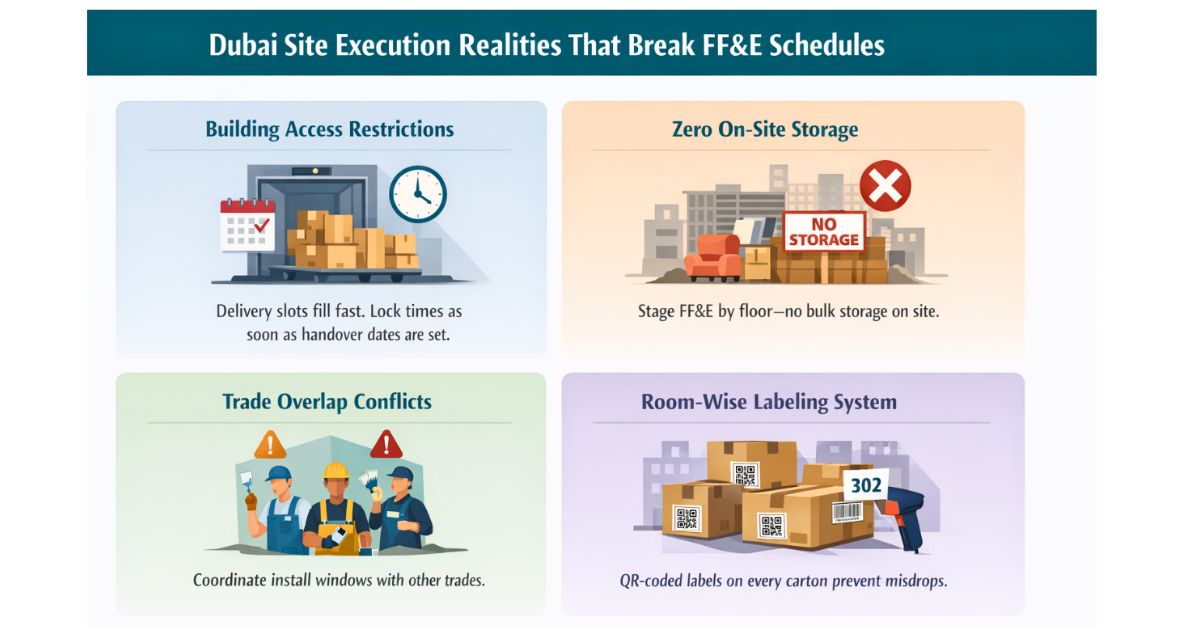

Generic FF&E logistics coordination plans fail because they ignore the specific operational constraints on every Dubai hotel site. These four realities must be built into your hotel opening date FF&E timeline in Dubai from day one.

Delivery slots are not flexible in Dubai. Freight lifts and loading bays operate on pre-approved time windows. During peak fit-out phases, slot availability can stretch into weeks. Delivery slots must be locked the moment floor-wise handover dates are confirmed.
Hotel sites are not warehouses. Most Dubai hotels have no usable laydown space. Bulk FF&E deliveries create congestion and damage risk. Floor-wise, staged deliveries tied directly to handover dates eliminate on-site storage entirely.
Multiple trades, one floor. Painters, joinery teams, MEP contractors, and FF&E installers often overlap. Without a coordinated staging and installation window approved by the PMC, productivity collapses and rehandling increases.
Unlabeled cartons guarantee chaos. On 200+ room hotel projects, even one untagged pallet causes misdrops. Every carton must carry room-wise or QR-coded labels. On-site relabeling wastes time and increases damage risk.
Many Dubai hotel sites within master communities require contractor vehicle pre-registration and NOC approvals before any delivery vehicle enters the site. These approvals can take 3 to 5 working days. Failing to include this in the delivery window planning is a common cause of last-minute slot failures on opening-month delivery runs.
FF&E delivery coordination with the main contractor and PMC requires a shared delivery window calendar – not just vendor ETAs forwarded by email. The PMC must approve each floor's delivery window against the live construction programme, confirming that MEP, screed, floor finishes, and joinery sign-off are complete before any FF&E touches that floor.
Key coordination checkpoints: contractor handover certificate per floor → PMC delivery window approval → freight lift slot confirmation → staging zone clearance from the site manager → installer mobilisation confirmation. Each gate must be cleared in sequence. Skipping any one gate creates the congestion, damage, and re-handling scenarios that push Dubai hotel opening dates back by days or weeks.
FF&E delivery window planning on Dubai hotel sites aligns with broader construction project scheduling principles recognised by the Project Management Institute (PMI), which defines phased handover sequencing as a critical path discipline for fit-out projects. Separately, RICS project management guidelines for interior fit-outs recommend QC gate milestones as mandatory hold points before any loose furniture installation commences on an active construction site.
Managing a hotel FF&E delivery schedule in Dubai across 10 to 15 vendors simultaneously creates accountability gaps that no spreadsheet can close. A single-window procurement partner consolidates production tracking, pre-dispatch QC, FF&E logistics coordination, and floor-wise delivery sequencing into one plan with one point of accountability.
Factor | Multi-Vendor Direct | Single-Window (Arcedior) |
BOQ freeze and spec lock | Each vendor separately | One unified input process |
Production milestone tracking | Chasing 12+ contacts weekly | One tracker, one contact |
Pre-dispatch QC evidence pack | Inconsistent or absent | Standardized across all vendors |
Floor-wise delivery sequencing | Vendors deliver independently | Consolidated and coordinated by floor |
Room-wise labeling system | Often missing entirely | QR system, standardized |
Snag closure accountability | Disputed across multiple vendors | Single accountability channel |
Spares strategy (3 to 5%) | Often reordered too late | Built into the delivery plan |
On 200+ room hospitality projects, floor-wise sequencing has reduced the final two-week punch-list backlog by up to 40% compared to bulk deliveries, because every item reaches the right room on the right floor within its install window, not in a congestion pile at the loading bay.
A hotel FF&E delivery schedule in Dubai is not a logistics afterthought; it is the operational backbone your opening date stands on. Every correctly built floor-wise FF&E delivery sequence, every enforced pre-dispatch QC gate, and every room-wise label on the right carton is a day you do not lose before opening. The teams that open on time build their FF&E delivery sequencing plan before production starts, not after the first container is already on the water.
Arcedior's single-window model brings production tracking, QC gates, FF&E logistics coordination, and phased handover FF&E planning under one accountable partner, so your floor-wise delivery calendar holds from day one to opening day.
Opening date fixed? Share your BOQ, Dubai location, target opening month, and floor-wise handover plan. Arcedior will revert with a delivery sequencing calendar, QC gates, and logistics coordination framework built around your hotel opening date, not around a shipping ETA.
Build the hotel FF&E delivery schedule backwards from confirmed floor-wise handover dates. Lock BOQ and finish approvals first, then track production milestones weekly per vendor. Run pre-dispatch QC with a full evidence pack, pre-book delivery slots, and deliver only what installs within 48 to 72 hours per floor. Room-wise labeling eliminates misdrops on Dubai hotel sites.
The FF&E delivery schedule is not tied to the floor-wise construction handover calendar. When furniture arrives before MEP, joinery, or floor finishes are complete, it creates congestion, damage risk, and double-handling costs that push the Dubai hotel opening date back. FF&E logistics coordination must be sequenced against confirmed site readiness per floor, never against shipping ETAs.
Sequence by floor handover order, then by zone within each floor, then by install dependency. Guestrooms before corridors, corridors before public areas. Each FF&E delivery window should cover only what the install team completes that day. Never leave items overnight in unsecured areas on an active Dubai hotel construction site.
A hotel furniture delivery schedule template for Dubai must include floor, zone, room type, item category, quantity, vendor, production and QC status, dispatch date, ETA, booked delivery slot, staging location, installer window, and a reconciliation log tracking received versus expected quantities and damage issues per room and zone.

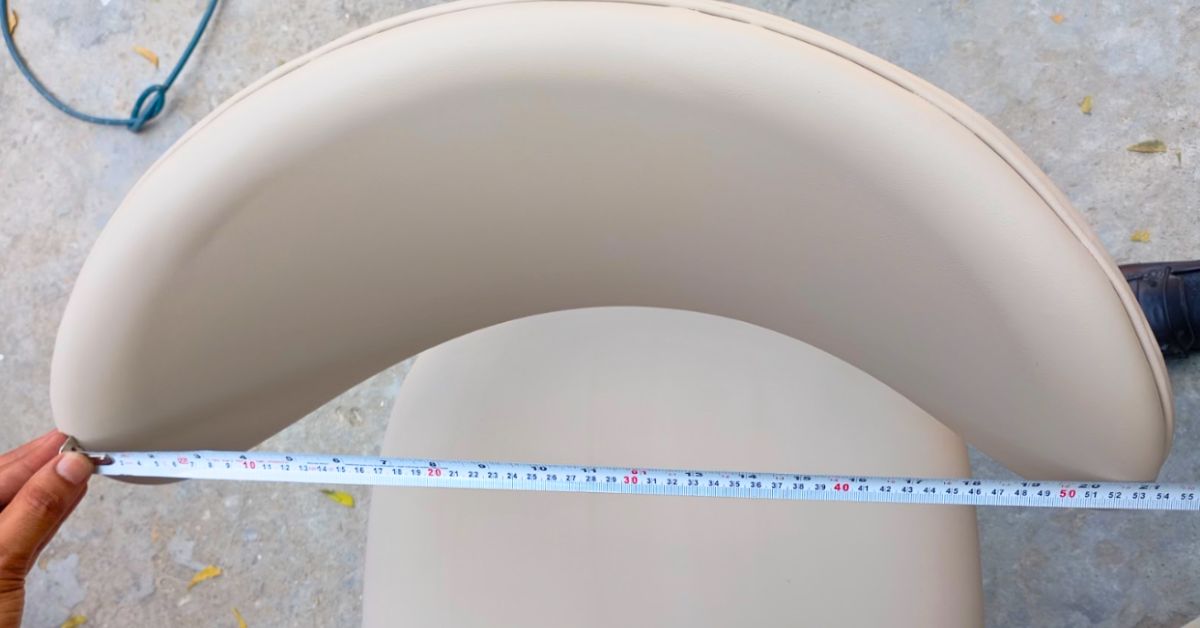

The pre-dispatch QC checklist before FF&E delivery must cover finish match against approved sample, dimensional tolerances, hardware operation, surface inspection, packaging validation with edge and corner guards, and full packing list accuracy. A photo and video evidence pack must accompany every shipment document for site cross-reference during reconciliation.
A room-wise labeling system using QR-coded carton labels mapped to a zone label plan is the most reliable prevention method. Each label must include room number, floor, item description, and quantity. Reconcile against the packing list immediately on arrival, before unboxing begins, and log every discrepancy against the BOQ that same day.
BOQ freeze and spec lock must happen before the RFQ goes to any vendor. Any change after production starts costs two to six weeks in rework, resampling, or reorder lead time. For Dubai hotel FF&E timelines with a fixed opening date, the locked BOQ is the foundational input that every downstream milestone depends on.
Yes. A single-window procurement partner consolidates production tracking, QC gates, FF&E logistics coordination, and floor-wise delivery sequencing across all vendors into one plan. This eliminates the gaps between vendors that create misaligned ETAs, inconsistent QC evidence, and conflicting site arrivals that no direct multi-vendor model can manage reliably.
A live snag log with item description, room number, assigned owner, resolution method, and target date is essential. Log snags the day they are discovered, not in a final walkthrough. Floor-by-floor punch-list and snag closure tracked alongside install progress prevents the backlog that collapses pre-opening timelines on Dubai hotel projects.
Damage prevention starts at packaging: edge guards, corner guards, and moisture protection rated for the Dubai climate and sea freight transit. On-site, use padded trolleys, protect finished floor surfaces, and stage directly into rooms. Deliver only what installs within 48 hours to eliminate stacking, re-handling, and secondary-move damage completely.
